Equipment selection support guide

How to select food processing equipment

Build a traceable equipment decision from intended use and accepted output through hygiene, safety, integration, product trials and contractual acceptance.

What is the correct way to select food processing equipment?

Define the finished product, raw-material range, process conditions and accepted output first. Convert them into a user requirement specification, then compare only technically compliant equipment for hygiene, safety, line integration, lifecycle cost and support. Complete representative product trials and agree measurable factory and site acceptance tests before purchase.

Who should use this guide?

Food manufacturers

Buying a first machine, expanding capacity or adding a new SKU.

Project engineers

Defining equipment interfaces, utilities, layouts and acceptance tests.

Procurement teams

Comparing supplier proposals against one controlled requirement set.

Eight-step food equipment selection framework

Define intended use

State products, raw materials, process limits, operators, cleaning regime, operating environment and foreseeable misuse. A machine suitable for dry dough may not be suitable for exposed ready-to-eat food or aggressive wet cleaning.

Describe accepted product

Specify weight, dimensions, shape, temperature, texture, fill ratio, appearance, tolerance and reject definition. Use accepted finished output as the commercial basis.

Map the complete process

Identify upstream supply, preparation, forming, thermal treatment, cooling, inspection, buffering and packaging. The selected machine must fit the process interfaces, not operate as an isolated catalogue item.

Calculate required effective capacity

Start from daily accepted demand and operating time. Include product changeovers, sanitation, planned stops, start-up loss, rejects and realistic operating efficiency.

Write the user requirement specification

Separate mandatory requirements, preferred features and supplier proposals. Define evidence for every mandatory item so compliance can be tested rather than assumed.

Screen hygiene, safety and integration

Review product-contact materials, cleanability, drainage, access and cross-contact risks together with mechanical, electrical, ergonomic and control-system risks.

Run representative product trials

Test difficult and normal products using representative raw materials. Record stable accepted output, quality, rejects, settings, operator interventions and cleaning observations.

Agree FAT, SAT and handover

Define test scope, duration, instruments, responsibilities, pass criteria, punch-list closure, training, documentation, spares and final site performance before the purchase order is released.

Minimum data for a useful equipment enquiry

Requirement groupInformation to provide
ProductFood name, recipe class, photos or drawings, target weight and dimensional tolerances.
Raw materialTemperature, moisture, viscosity, particle or inclusion size, variability and allergen status.
ProcessRequired operation, critical temperatures or times, infeed condition and discharge condition.
CapacityAccepted kg/h, pieces/min or packs/min; daily target; shifts; operating days and peak demand.
CleaningWet, dry, COP or CIP method; chemicals; temperature; frequency; changeover and validation needs.
FactoryRoom dimensions, access route, floor loading, drainage, environmental conditions and zoning.
UtilitiesVoltage/frequency, installed power limits, water, steam, compressed air, refrigeration and exhaust.
InterfacesUpstream feed, downstream acceptance, conveyor heights, controls, communication and buffer policy.
ComplianceDestination-market regulations, company standards, guarding, documentation and certification needs.
AcceptanceTest product, duration, sample plan, capacity, quality, reject, sanitation and documentation criteria.
Food processing machine surrounded by product output process utility sanitation maintenance and expansion requirements
A defensible equipment choice translates the product, process, capacity, sanitation, utility and service requirements into acceptance criteria.

Select capacity from accepted output

Preliminary nominal capacity requirementRequired nominal output = accepted production target / planned operating efficiency

If accepted demand is 500 kg/h and a defensible preliminary operating efficiency is 80%, the screening requirement is 625 kg/h nominal. This is only a starting point: batch timing, product behavior, rejects and the constraint machine must still be checked.

Do not apply one universal efficiency value. Establish assumptions from the product, process, shift pattern, sanitation schedule and comparable operating evidence. A line can only sustain the effective capacity of its constraint stage.

Compare compliance before price

Process fitProduct range, operating window, stable quality and recipe control
Accepted performanceSustained good output, rejects, changeover and recovery
Hygienic fitMaterials, cleanability, drainage, access and allergen controls
Safety and ergonomicsRisk reduction, guarding, access, lifting and operator interaction
Factory integrationFootprint, utilities, environment, controls and line interfaces
Lifecycle supportMaintenance, wear parts, documentation, training and response
Total operating effectYield, labor, energy, water, sanitation time and downtime
Commercial clarityScope boundaries, exclusions, delivery, warranty and acceptance

Hygiene and safety are separate, mandatory reviews

Hygienic design protects food from contamination and supports effective cleaning. Machinery safety protects people across transport, installation, operation, cleaning, maintenance and foreseeable misuse. A machine can perform well and still fail one of these reviews.

Do not accept a material claim as a complete hygienic assessment

Stainless steel alone does not prove hygienic suitability. Review geometry, joints, seals, hollow sections, fasteners, drainage, surface condition, access, dismantling, cleaning method and installation interfaces for the defined intended use.

Use the hygienic design support guide →

Define FAT and SAT before ordering

Factory Acceptance Test

Before shipment, verify agreed construction, controls, alarms, recipes, guarding, documentation and product performance that can be tested at the supplier's facility.

  • approved test procedure;
  • representative product and conditions;
  • calibrated measurement method;
  • pass/fail criteria and deviations;
  • punch-list responsibility and retest.

Site Acceptance Test

After installation, verify equipment under the final utility, layout, line-interface and operating conditions. SAT does not replace commissioning or long-term process validation.

  • installation and utility checks;
  • upstream/downstream integration;
  • safety and interlock checks;
  • site product and performance test;
  • training, handover and open-item closure.

IEC 62381:2024 specifically structures FAT, FIT, SAT and SIT for automation systems. For food equipment, adapt the test plan to the machine, product and contractual specification rather than claiming that this automation standard certifies food-process performance.

What should a supplier's trial video prove?

Trial-evidence guidance reviewed: 12 September 2026.

Use a demonstration to identify questions for the product trial. Before treating the result as acceptance evidence, ask the supplier to connect the recording to a named sample, machine configuration and measured result. Agree this evidence pack alongside the FAT procedure.

  1. Identify the input. Record the sample or batch ID, product variety, preparation and relevant measured condition. Link these details to the material shown entering the machine.
  2. Identify the setup. Record the machine model, installed tooling and agreed operating settings. Confirm whether the demonstrated configuration is the one included in the quotation.
  3. Show the agreed run. Request an uninterrupted record of the agreed test interval, supported by a run log for stops, adjustments and operator interventions. A highlight clip can accompany the record.
  4. Measure the result. Link the output sample IDs to dimensions, accepted quantity, rejects and elapsed time using the agreed sampling and measurement method. Keep close-up photographs with a scale where dimensions matter.
  5. Close the open points. Record deviations, exclusions, responsibilities and any retest required. Confirm separately what will be checked after installation during SAT.

For example, Urschel describes product trials with a written report and optional photographs or video, including remote attendance. Its cheese-dicing application guidance also identifies product temperature, moisture and speed settings as influences on the result. These are external examples supporting the need to document actual trial conditions; they are not HELPER service commitments or performance figures.

A caption stating a cut size and a close-up of finished pieces do not establish a measured tolerance or sustained accepted output. In the externally published Urschel Asia cheese-stick demonstration, the selected frame shows product and a size caption. Use that distinction when requesting the corresponding measurement sheet from your supplier. This is third-party footage, not a HELPER test; no capacity or dimensional compliance is inferred from it.

Watch the trial: from product input to finished pieces

Watch for the material presented at the feed area near 0:02 and the finished-product close-up with a size caption near 0:27. Compare what is visible with the evidence checklist above.

Clicking Load video connects to YouTube. Then press Play in the player. YouTube may use cookies and process device and usage information under its own privacy policy.

External video: Urschel Asia. This is not HELPER equipment or a HELPER acceptance test. The written explanation above remains the basis for interpreting the demonstration. Open on YouTube if the player is unavailable.

For a HELPER enquiry, review the relevant equipment family and attach your product targets, trial conditions and open acceptance questions to the project brief. Then discuss the proposed trial scope.

Worked selection example: filled dumpling line

Requirements translated into testable criteria

Product
22 g filled dumpling, defined wrapper thickness, filling ratio and seal-quality limits.
Accepted demand
12,000 good pieces/hour after rejects, with two planned product changeovers per shift.
Process interfaces
Controlled dough sheet and filling supply; tray loading before freezing.
Hygiene
Wet-cleaned food zone, allergen changeover, removable tooling and inspection access.
Trial
Actual dough and filling over a defined sustained run, recording good pieces, rejects and operator stops.
Acceptance
Agreed output and weight tolerance, seal integrity, changeover time, cleaning access and complete documentation.

The correct comparison is not simply machine A versus machine B in pieces per minute. It is which compliant system repeatedly produces the specified accepted dumpling within the actual factory constraints.

Common selection mistakes

  • Choosing from machine name or maximum catalogue speed before defining the finished product.
  • Comparing nominal output with accepted output without a common efficiency and reject basis.
  • Assuming one successful sample proves the entire raw-material and SKU range.
  • Reviewing stainless-steel grade but not equipment geometry, drainage or cleaning access.
  • Leaving conveyors, cooking, cooling, packaging and control interfaces outside the supplier scope.
  • Defining FAT after manufacturing is complete, when disagreements are expensive to correct.
  • Comparing purchase price before confirming technical compliance and lifecycle effects.

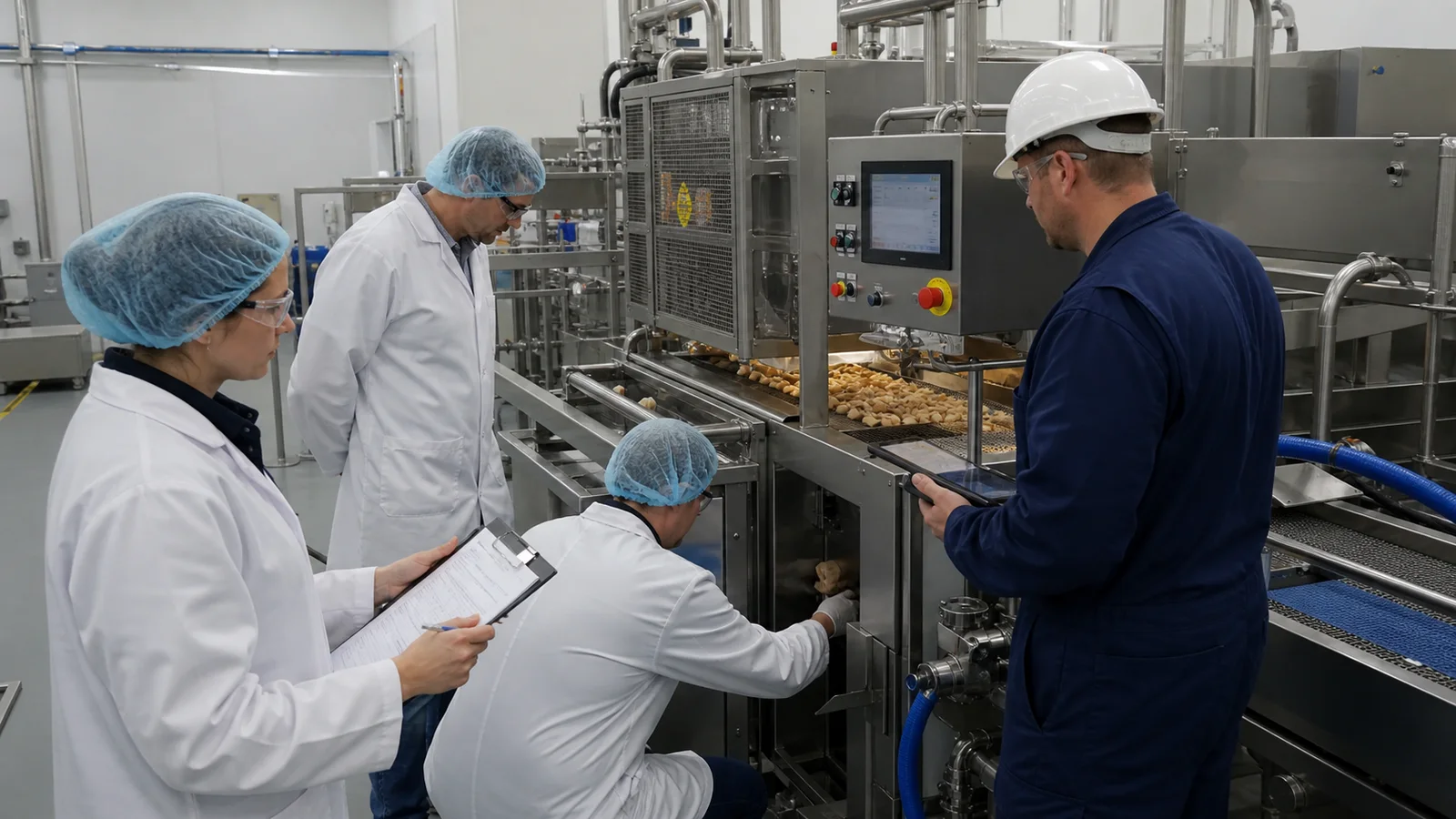

Customer project team conducting a factory acceptance test on food processing equipment
Factory acceptance testing confirms output, product quality, safety, utilities, access and cleaning before shipment.

Sources and current-edition notes

Research date: 7 August 2026. This guide provides preliminary equipment-selection guidance and does not replace jurisdiction-specific legal review, food-safety validation, machinery risk assessment or a signed technical specification.

Food processing equipment selection FAQ

What information is needed before selecting food processing equipment?

Define the finished product, raw-material range, accepted output, process conditions, cleaning method, utilities, line interfaces and measurable acceptance criteria.

Is nominal machine capacity enough for equipment selection?

No. Use accepted output after realistic operating efficiency, rejects, changeovers, cleaning and upstream or downstream constraints.

What is the difference between FAT and SAT?

FAT is performed before shipment at the supplier or integration site. SAT is performed after installation to verify equipment in final site conditions and interfaces. The exact scope must be agreed in the contract.

Should the lowest-priced compliant machine be selected?

Price comparison begins only after technical compliance. Then compare installed cost, utilities, labor, yield, sanitation time, maintenance, spares, downtime risk and lifecycle support.
